Burn Rate in Project Management (PMP)

Table of Contents

Burn rate measures how quickly a project is consuming its budget relative to the value of work actually completed, calculated as Actual Cost divided by Earned Value. A burn rate above 1.0 signals a project is spending faster than it is generating value; below 1.0 signals the opposite. The term originated in startup finance and was later adopted into Agile and PMP-tested project management vocabulary.

What Is Burn Rate in Project Management?

Burn rate is a cost-efficiency metric that measures how fast a project is consuming its allocated budget relative to the value of work completed, expressed as the ratio of Actual Cost to Earned Value. Project managers track burn rate to catch budget overruns early, particularly in Agile environments where sprint-level cost tracking matters.

What Is the Burn Rate Formula?

The burn rate formula is Burn Rate = AC / EV, where AC is Actual Cost and EV is Earned Value. The formula inverts the inputs used in Cost Performance Index, which is why the two metrics require opposite interpretation despite using the same underlying data.

How Do You Calculate Burn Rate?

A project manager calculates burn rate by dividing Actual Cost by Earned Value at a given reporting date.

A sprint has an Actual Cost of $84,000 and an Earned Value of $70,000.

Burn Rate = $84,000 / $70,000 Burn Rate = 1.2

A burn rate of 1.2 indicates the sprint is consuming budget 20% faster than the value of work completed justifies — the project is over budget.

A second sprint has an Actual Cost of $60,000 and an Earned Value of $75,000.

Burn Rate = $60,000 / $75,000 Burn Rate = 0.8

A burn rate of 0.8 indicates the sprint is under budget, consuming resources more slowly than the value of completed work would suggest.

How Do You Interpret Burn Rate?

A burn rate greater than 1.0 indicates a project is over budget, a burn rate less than 1.0 indicates a project is under budget, and a burn rate of exactly 1.0 indicates spending is tracking exactly to plan.

  • Burn Rate > 1.0 — over budget; the project is spending faster than it is earning value.
  • Burn Rate = 1.0 — on budget; spending exactly matches the value of work completed.
  • Burn Rate < 1.0 — under budget; the project is spending slower than the value of work completed.

How Is Burn Rate Related to Cost Performance Index (CPI)?

Burn Rate is the mathematical reciprocal of CPI: Burn Rate = 1 / CPI, and CPI = 1 / Burn Rate. Because the two formulas invert each other, a burn rate above 1.0 always corresponds to a CPI below 1.0, and a burn rate below 1.0 always corresponds to a CPI above 1.0.

Using the first sprint example: CPI = EV / AC = $70,000 / $84,000 = 0.833. Taking the reciprocal, 1 / 0.833 = 1.2, matching the burn rate calculated directly. Mixing up which formula signals “over budget” is the most common error project managers make when moving between the two metrics.

How Is Burn Rate Used in Agile Environments?

In Agile environments, cost burn rate tracks how quickly a sprint consumes its allocated budget, while velocity burn rate tracks how quickly a team completes story points — two related but distinct metrics that share a name. A team can show a healthy velocity burn rate while running an unfavorable cost burn rate, or the reverse, since one measures scope progress and the other measures financial efficiency.

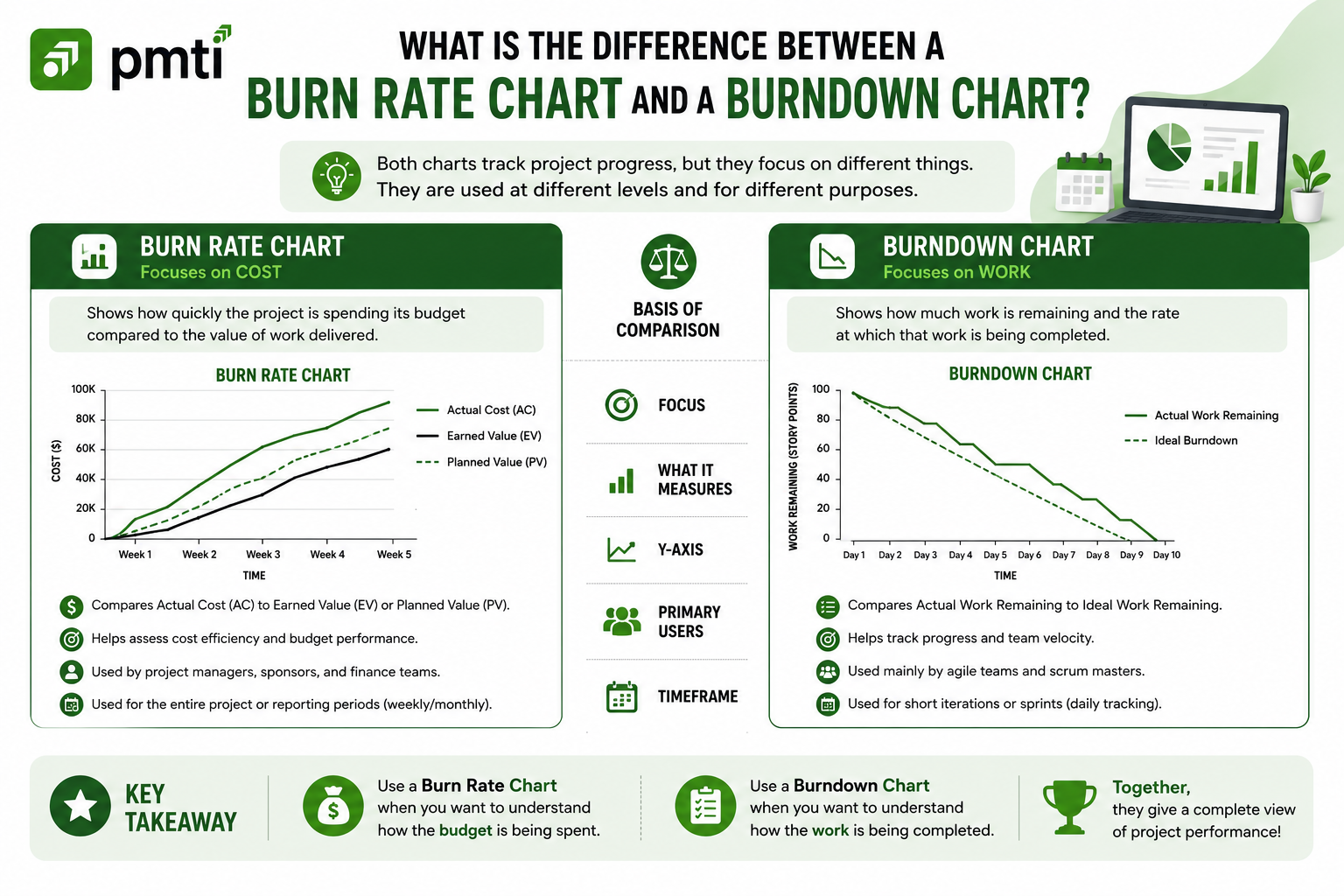

What Is the Difference Between a Burn Rate Chart and a Burndown Chart?

A burn rate chart plots actual spending against planned spending over time as a financial tracking tool, while a burndown chart plots remaining work toward zero as a schedule and scope tracking tool. The two charts are frequently confused due to their similar names, but they answer different questions: burn rate asks “are we spending appropriately,” while burndown asks “are we finishing on time.”

Why Is Tracking Burn Rate Important?

Tracking burn rate matters because it surfaces budget problems early enough for corrective action, before a sprint or project fully depletes its funding. A project manager who reports burn rate to stakeholders regularly avoids the far more difficult conversation that follows an unanticipated budget shortfall.

  • Detects budget overruns early, while corrective options are still available.
  • Informs stakeholder communication with a single, easy-to-interpret ratio.
  • Supports sprint-level financial decisions in Agile and hybrid delivery environments.

How Does Burn Rate Appear on the PMP Exam?

The PMP exam tests burn rate less consistently than core EVM formulas like CPI and SPI, but it appears in Agile and hybrid-context questions given the exam’s coverage of predictive, agile, and hybrid approaches. Candidates should expect burn rate questions to test both direct calculation and its inverse relationship to CPI.

Sample Question 1: A sprint has AC = $45,000 and EV = $50,000. What is the burn rate, and what does it indicate? A) 1.1; over budget B) 0.9; under budget C) 0.9; over budget D) 1.1; under budget

Sample Question 2: A sprint has AC = $132,000 and EV = $110,000. What is the burn rate? A) 0.83 B) 1.0 C) 1.2 D) 1.5

Sample Question 3: A project’s CPI is calculated at 1.25. What is the corresponding burn rate? A) 1.25 B) 0.8 C) 1.0 D) 0.75

Sample Question 4: A stakeholder wants to see whether the team is completing planned work on schedule, not whether spending is tracking to budget. Which tool should the project manager use? A) Burn rate chart B) Burndown chart C) Cost Performance Index D) Estimate at Completion

Answers: 1) B — Burn Rate = $45,000 / $50,000 = 0.9, indicating the project is under budget. 2) C — Burn Rate = $132,000 / $110,000 = 1.2. 3) B — Burn Rate = 1 / CPI = 1 / 1.25 = 0.8. 4) B — a burndown chart tracks remaining work toward completion, while a burn rate chart tracks spending against budget.

Frequently Asked Questions

Is Burn Rate an Official PMBOK Term?

Burn rate is not a formally defined PMBOK Guide term in the same way CPI or EAC are, but it appears consistently across PMP prep resources and Agile project management practice, particularly for sprint-level cost tracking. Candidates should understand the concept and formula even though it is not guaranteed to appear on every PMP exam version.

Is Burn Rate the Same as CPI?

Burn rate and CPI use the same two inputs but are not the same metric — burn rate is calculated as AC / EV, while CPI is calculated as EV / AC, making the two exact reciprocals of each other. A burn rate above 1.0 always corresponds to a CPI below 1.0, and confusing which direction signals “over budget” is a common exam trap.

What Is a “Good” Burn Rate?

A burn rate at or near 1.0 is generally considered healthy, indicating spending is tracking closely to the value of work completed. A burn rate persistently above 1.0 across multiple sprints signals a systemic cost efficiency problem rather than a one-time anomaly.

Is Burn Rate Only Used in Agile Projects?

Burn rate is most commonly associated with Agile and sprint-based environments, but the underlying AC/EV calculation applies equally to traditional, predictive projects tracking cost performance over any reporting period. The term is simply used more frequently in Agile contexts due to the shorter, more frequent reporting cycles sprints create.
